The Great Pyramid of Giza took approximately 20 years to build, according to most Egyptological estimates. That figure comes from a single historical source, a Greek historian writing over 2,000 years after the fact, cross-checked against physical evidence at the site itself and the two don’t always agree as neatly as popular articles suggest.
Short answer: roughly 20 years for the pyramid itself, during the reign of Khufu (about 2560 BC). Adding the preparatory work — levelling the site, opening quarries and cutting the causeway — pushes the total closer to 30 years. The 20-year figure comes from Herodotus, and holds up against three independent checks: construction arithmetic, Khufu’s reign length, and a work diary kept during the build.
✍️ Write YOUR Name in Real Hieroglyphics
See how the ancient Egyptians would have written your name — free interactive tool.
Try It Now →
Here’s where the number actually comes from, and why “about 20 years” is more solid than it might sound for something built 4,500 years ago.
The Original Source: Herodotus
The 20-year figure traces back to the Greek historian Herodotus, who visited Egypt around 450 BCE roughly 2,000 years after the Great Pyramid was completed. In his account, Herodotus wrote that the pyramid took 20 years to build, following a separate 10-year project to construct the causeway and underground chambers.
The problem: Herodotus was writing two millennia after the fact, based on stories told to him by Egyptian priests and guides. He wasn’t an eyewitness, and some of his other claims about Egypt including a widely repeated claim about slave labor have since been contradicted by archaeological evidence. So Egyptologists don’t take his number on faith. They test it.

Testing the Number Against the Pyramid Itself
Modern estimates work backward from construction math. The Great Pyramid contains roughly 2.3 million blocks, with an average weight around 2.5 tons. If construction spanned 20 years, that works out to placing a block roughly every two to three minutes, assuming a 10-hour workday a demanding but physically plausible pace for a well-organized crew, especially once you account for the fact that different sections of the pyramid required different amounts of precision and labor.
This math is one of the stronger pieces of evidence supporting Herodotus’s number. If the real build time had been dramatically shorter, say five years, the placement rate required would push into implausible territory even for a highly skilled workforce. If it had taken far longer, say 50 years, the pace would be almost leisurely compared to what we know about ancient Egyptian labor organization from other massive building projects of the era.
What the Pharaoh’s Reign Tells Us
There’s a second independent check: the reign of Pharaoh Khufu, who commissioned the pyramid as his tomb. Historical king lists and inscriptions suggest Khufu ruled for somewhere between 23 and 26 years. Since the pyramid needed to be functionally ready by the time of his death a pharaoh’s tomb wasn’t something you could finish late a build time in the low-to-mid 20s fits neatly within a realistic portion of his reign, leaving time for the temple complex and other associated structures.
This is the kind of cross-referencing Egyptologists rely on constantly: no single source is treated as gospel, but when a 2,000-year-old historical account, physical construction math, and reign-length records all point to roughly the same window, confidence in the estimate goes up considerably.
Did the Timeline Include Off-Seasons?
Almost certainly, yes — and this matters for understanding how 20 years were used, not just how many. Evidence from the nearby workers’ village suggests labor was organized around the Nile’s annual flood season, when farming became impossible and a large seasonal workforce became available for state building projects. Skilled quarrymen, stonemasons, and engineers likely worked the site year-round, while the general labor pool swelled during flood months.
That means the 20-year timeline wasn’t 20 years of uniform, constant effort it was a sustained, multi-decade project with a permanent core team and a much larger seasonal surge workforce, which is part of why the logistics of the build are considered as impressive as the engineering itself.
Also Read How Were the Great Pyramids Actually Built?
How This Compares to Other Pyramids
| Pyramid | Builder | Approx. date | Height | What it tells us |
|---|---|---|---|---|
| Step Pyramid, Saqqara | Djoser | c. 2670 BC | 62 m | The first. Built in stages as the design changed mid-project |
| Meidum | Sneferu | c. 2610 BC | collapsed | The outer casing failed. Egyptians were still learning the limits |
| Bent Pyramid | Sneferu | c. 2600 BC | 105 m | The angle was changed partway up, almost certainly for stability |
| Red Pyramid | Sneferu | c. 2590 BC | 105 m | The first successful true pyramid |
| Great Pyramid | Khufu | c. 2560 BC | 146.6 m | The largest. Roughly 2.3 million blocks |
| Khafre | Khafre | c. 2530 BC | 143.5 m | Looks taller because it sits on higher ground |
| Menkaure | Menkaure | c. 2510 BC | 65 m | Much smaller. The great age was already ending |
The row that matters most for the timeline question is Sneferu. He built three pyramids in a reign of roughly twenty-four years — including two the size of the Red Pyramid. That makes twenty years for one pyramid, even a larger one, look entirely plausible rather than extraordinary.
Not every pyramid took two decades. The Bent Pyramid and Red Pyramid, both built earlier under Pharaoh Sneferu (Khufu’s father), show evidence of construction problems and design changes mid-build, suggesting variable and sometimes troubled timelines. The Great Pyramid, by contrast, shows remarkably few signs of major design revision once construction began — another indirect clue that its builders had learned from earlier projects and executed this one with unusual efficiency.
The Diary That Confirmed the Timeline
For most of the twentieth century, every estimate rested on Herodotus plus arithmetic. Then in 2013 a French mission excavating at Wadi al-Jarf on the Red Sea coast found something nobody expected: a stack of papyri from Khufu’s own reign.

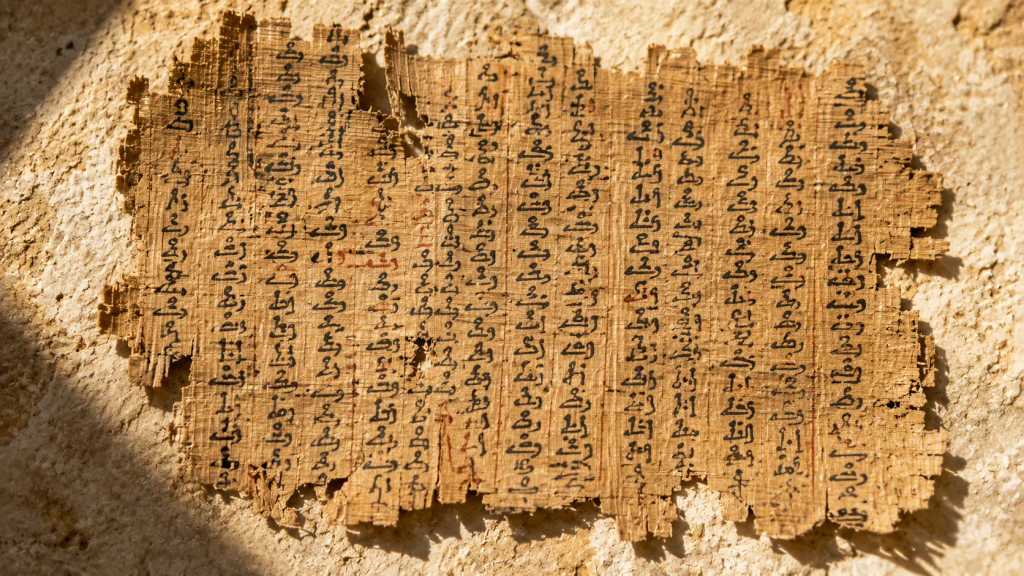

They are the oldest inscribed papyri ever found in Egypt — and one of them is essentially a delivery schedule. An inspector named Merer, in charge of a crew of about two hundred men, logged his team’s limestone runs from Tura to Giza day by day: loading, sailing, unloading, rest days. For anyone estimating the build time, that rhythm matters — it shows material arriving on a steady cadence rather than in seasonal bursts.
Merer’s diary records his team ferrying fine white limestone from the quarries at Tura across the Nile to the Giza construction site. It logs trips, timings and stops, in the flat administrative language of a man filling in a form.
Two things about it matter for the timeline.
First, it is dated to year 27 of Khufu’s reign — and the work Merer describes is casing stone, the smooth outer limestone that goes on last. If the outer casing was still being delivered in year 27, the project was still running deep into Khufu’s reign, exactly as a roughly two-decade build would predict.
Second, it shows the logistics running smoothly by that point — a routine supply operation, not a crisis rush. That fits a long, planned schedule far better than a compressed one.
Who Was Actually Doing the Work
Any build-time estimate depends on how many people you assume were working, and that number has been revised sharply downward over the past few decades.

Herodotus claimed 100,000 men. Modern estimates based on the excavated workers’ settlement at Giza put the figure closer to 20,000–30,000, split between a permanent skilled core and rotating conscripted crews.
That settlement matters. Excavations there revealed bakeries and breweries running at industrial scale, vast quantities of cattle, sheep and goat bone, and workers’ cemeteries where the skeletons show healed fractures and signs of medical care. These were fed, housed and cared-for workers, not slaves — a point covered in more detail in our article on how the pyramids were built.
The rotating labour obligation that supplied those crews is exactly what the state’s record-keeping existed to track. Our piece on the ancient Egypt census covers how households were registered and who owed service.
Why the Estimate Still Has Uncertainty
Twenty years is the working figure, not a proven fact. Three things keep it approximate.
Khufu’s reign length is itself disputed
Old Kingdom dates were recorded by counting periodic cattle censuses rather than regnal years, and whether those counts happened annually or every second year varies by reign. Merer’s diary references year 27, which pushed some earlier estimates upward. If Khufu ruled longer than assumed, the pyramid could have been built at a more relaxed pace.
Nobody knows exactly how blocks were raised
Ramps were certainly used, but no substantial ramp survives at Giza and the models proposed — straight, spiral, internal, staged — imply quite different labour requirements. In 2018, archaeologists at the Hatnub quarry uncovered a hauling setup of ropes and wooden posts that could shift heavy stone up far steeper gradients than scholars had thought possible — and steeper hauling means fewer men per block, which feeds directly into the workforce math.
Preparation time is often left out
Herodotus described ten years of preparatory work before the pyramid itself — levelling the site, cutting the causeway, opening quarries. Whether you count that depends on where you draw the line. Including it gives roughly thirty years from first survey to finished monument.
A 2026 simulation of the timeline
The twenty-year figure was tested computationally in March 2026. Writing in npj Heritage Science, Vicente Luis Rosell Roig — an independent researcher with a doctorate in computer engineering — simulated the whole build minute by minute.
The arithmetic problem is stark. Roughly 2.3 million blocks inside a reign of about 27 years works out at one block roughly every three minutes, continuously.
Roig’s model found that a single ramp could not sustain that — it produced a build time closer to fifty years. Four helical channels running simultaneously, one per face, could. His result was a median on-site duration of 13.8 to 20.6 years, rising to 20 to 27 years once quarrying, river transport and seasonal pauses are included.
That lands almost exactly on Herodotus. Which is a striking result, and also where care is needed.
This is a simulation, not an excavation. It shows the twenty-year figure is achievable under a particular set of assumptions. It does not confirm that this is what happened, and no physical trace of the ramps it proposes has been found. Several outlets reported it as having solved the mystery; it has not.
What it does do is remove one objection. For years the twenty-year figure was doubted partly because nobody could show a logistics method that made it work. Now there is at least one model that does, with the code published openly so others can test it.
What We Have Learned Since
The pyramid is still producing new information. In 2017 the ScanPyramids team peered inside it with muon tomography, which uses cosmic-ray particles passing through stone to map density differences without drilling. They announced in Nature a large void above the Grand Gallery, at least 30 metres long; later work confirmed a second, corridor-shaped space behind the chevron blocks on the north face.
Nobody yet knows what either space was for. Candidates include construction relief chambers to redistribute load, or features connected to the building process itself.
If they turn out to be construction features, they may eventually tell us something about the sequence and pace of the build — which is to say the twenty-year figure is not a closed question.
Frequently Asked Questions
Is the 20-year figure definitely accurate? It’s the best-supported estimate, corroborated by construction math and reign-length records, but it ultimately traces back to a historical account written 2,000 years after the pyramid was completed. Egyptologists treat it as a strong estimate rather than a certainty.
How many blocks were placed per day? Based on a 20-year timeline and roughly 2.3 million blocks, workers placed blocks at a rate of several hundred per day when the site was at full operation.
Did construction happen year-round? Skilled workers likely operated year-round, while the general labor force expanded significantly during the Nile’s flood season, when farming was on hold.
Why did the pyramid need to be finished within Khufu’s reign? The pyramid served as Khufu’s tomb. Ancient Egyptian royal burial practices required the tomb to be ready at the time of the pharaoh’s death, which set a hard, if flexible, deadline on the project.
